China has a vast expanse of
land with intertwining rivers
and mountains, abounds in
lakes and reservoirs. The
survey of rivers and lakes as well as
the protection and exploitation of
these resources plays an important role
in Chinese economy. Cross-section
survey of water bodies is a key part
in hydrographic engineering survey.
Traditional methods of cross section
survey of a river such as theodolite
intersection, theodolite stadia,
electronic distance measurement,
depth-surveying bar, leadline, handlead
survey and echo sounder are the main
methods used for water bathymetry.
These methods are not only prone
to the inaccuracy of instruments,
distances, weather conditions,
intervisibility and communication
device, but also involved in tedious
workload which leads to low efficiency.
Some unfavorable factors such as the
flow of the water and the nonlinear
movement of the surveying ship
make measuring the depth of the
water more difficult. Lack of skills
and cooperation among surveyors might result in a low accuracy in the
position fix of cross-section points,
thus further affects the quality of
cross-section survey of the river. The
application of real-time kinematic
(RTK) GPS positioning technique has
opened a new avenue for the crosssection
survey of rivers (Wu, 2005).
Simultaneous utilization of RTK GPS
technology and the shipboard sounding
method (e.g. digital depth sounder)
will greatly improve the accuracy
and efficiency of cross-sectioning
survey of rivers(Qiu and Fong, 2002;
Qiu 2004; Zhang et al, 2002).
Basic principles of RTK GPS
For high accuracy GPS positioning,
"differential" GPS technique is used
where one receiver acts as "the base"
and the rover is positioned in a close
vicinity of the base to take advantage
of the nature of spatial correlation
of the GPS measurement errors such
as atmospheric delay, orbital errors,
clock errors and other factors in GPS
survey. Carrier phase measurements are taken and unknown integer cycles
of the carrier waves (i.e. the integer
ambiguities) need to be resolved prior
to the baseline solution is computed
through a "double-differenced"
process. Real-time data processing
of the GPS measurements at both
base and rover stations will make it
possible to obtain the stations' realtime
three-dimensional coordinates
with a centimeter level accuracy after a
successful initialization process (Hu et
al., 2005). In practice, a GPS receiver is
set on a base station whose coordinates
are precisely known. This GPS receiver
is connected with a data transmission
mechanism, which transmits the
observations and the base station
information to (one or more) remote
roving receivers. With the GPS signal
corrections transmitted in real time
from a reference receiver at a known
location and the information from
four or more visible satellites, a data
processing is carried out in real time
at the rover station, and the ambiguity
resolution, position and accuracy
of the rover station is obtained. The
critcal requirements of the RTK
techniques include: simultaneous
measurements from a minimum of
two GPS receivers, the separation of
the base and rover is less than 10-
20km and an on-the-fly data link.
Cross-section survey of
river in Jinjiang Reach
Introduction of the Project
Yangtze River is our mother river.
Chinese people have been living by the
mother river generation by generation
happily and benefited greatly. At the
same time, people have suffered a
lot when serious floods occurred.
According to historical records the
damage is low along lower reaches,
high along upper reaches and most
severe along middle reaches where
Hubei province is located. Taking
1998 as an example, Hubei Province
experienced a heavily flooding year
with 66 counties waterlogged, 1.54
million hectares of fertile farmland
flooded, and 3.83 billion RMB of
properties lost (Lei et al., 2000).

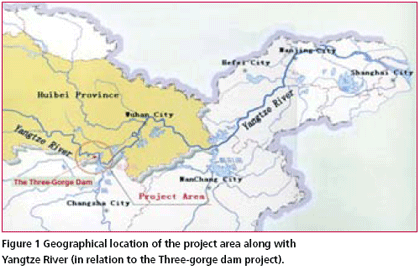

Figure 1 shows the middle reaches and
lower reaches of the Yangtze River
and the geographical location of the
survey project area respectively.
The portion between ZhiCheng and
ChengLingJi of the Yangtze River
is named Jingjiang Sector, which
is the crucial sector of the middle
reaches of the Yangtze River and
is 347.2 km long (OuChiKou is
considered as the dividing line of the
upper Jingjiang stretch and lower

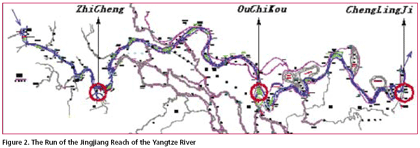

Jingjiang stretch respectively). Figure
2 shows the run of the Jingjiang
sector. The upper Jingjiang stretch
is a slightly curved bifurcated
reach, while the lower Jingjiang
Reach is a meandered reach. There
is an important dike along Yangtze
River - the Jingjiang embankment
in the north side of the river.
During the past several decades, the
Yangtze River has silt up and the
riverbed has been elevated significantly.
As a result, the flood water level of
the Yangtze River, similar to Huanghe
River, the second biggest river in
China, has risen by 1.5 to 2.5 meters
along the middle reach. Significant
changes have taken place in Jingjiang reach since the extraordinary floods
in 1998 and 1999, respectively. The
bifurcated reach has seen frequent
flow fluctuations of the mainstream,
erosion and sand deposition of the
shoals. The water level of the Three
Gorges Reservoir impoundment
reached 135 meters in June 2003 and
this led to the release of clear water
and scoured in the downstream of
the Three Gorges Dam. This made
Jingjiang reach threatened by frequent
bank failures, and the high risk of
Jingjiang flood has not been mitigated.
Therefore, to investigate the run of
the river along the Jingjiang reach is
of paramount importance. To meet the
needs of the assessment of potential
risk, emergency management, and
safety research of shipping and the
design of other Yangtz river related
engineering projects, river course
survey of the Yangtze River along
the Jingjiang reach is carried out.
The survey system requirements
Two sets of dual frequency geodetic
GPS receivers (Trimble 5700) are used
for the survey. The manufacturer's
specification of the receiver is: 10
mm+1ppm (Horizontal) and 20
mm+1ppm (Vertical) for kinematic
survey. One receiver is set as a base
station with an on-the-fly datalink
capability. The other GPS receiver
is a rover receiver that is used in the
survey ship. A laptop computer, SDH-
1C3D numeral echo sounder and other
necessary accessories (e.g. power
supply, and other fittings) are used. A
survey software package (Hypack), cadastral and topographical plotting
software CASS 4.0 are also used.

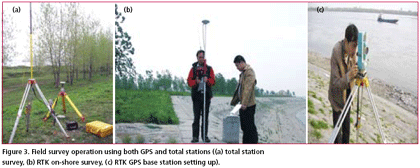

Figure 3 shows some field operation
and station setting up of the survey
using both GPS and a total station.
Cross-section survey
Along the riverbanks, there is a dense
flood protection forest. It would be
very labor intensive and resources
demanding if the conventional cross
sections survey technique is used to
carry out the survey, this is particularly
true for the control survey to connect
the area with n high-order ational
control points (Jiang et al., 2001; Zhao,
2005). In this aspect, the adoption of
the RTK GPS technology is ideal. First,
a preliminary design is conducted to
use the existing 1:2000 bathymetric
map of the Yangtze River. The crosssection
survey lines are designed to be
roughly perpendicular to the direction
of the river course. The positions of the
cross-sections control points are then
selected in open fields and monuments
are established. Each cross-section
usually consists of two cross-section
points and one in each side of the river.
Finally, the 3-D coordinates (both plane
coordinates and height) of the points
are surveyed. The three-dimensional
coordinates of each cross section
line are input into a laptop computer.
Appropriate geodetic datum parameters
in the laptop computer are chosen
priori to the computation of the results
and the WGS-84 coordinate system
and transverse Mercator projection
are used in the survey. The unit of the
measurements is meters and the area
surveyed is located at geographical position of longitude 111°18'00"E to
111°18'10"E and latitude 22°31'25"N
to 22°31'35"N respectively.
During GPS survey, a base station
needs to be located over a known point
and the base station should be chosen
in such a way that there is no potential
strong disturbance sources such as
electromagnetic wave, microwave,
high voltage power line disturbance
etc to avoid the effects of the GPS
signal reception and transmission.
Before formal survey commences,
known control points need to be
checked first so that any transformation
parameter mistakes or the data/
parameters errors can be detected and
corrected (Huang et al, 2001). Then
two points of a cross section line will
be measured then their coordinates
will be automatically produced in the
laptop computer and displayed on the
screen. At the same time, the laptop
computer will also show the position
and station number of the surveyor.
So the surveyor may know whether
he/she is on the cross section line
or not as well as knowing intervals
between the stations. The component
of the station 3-D coordinates from
GPS is also re-surveyed using an
Electronic Total Station (ETS) for
both confirmation and quality check.
